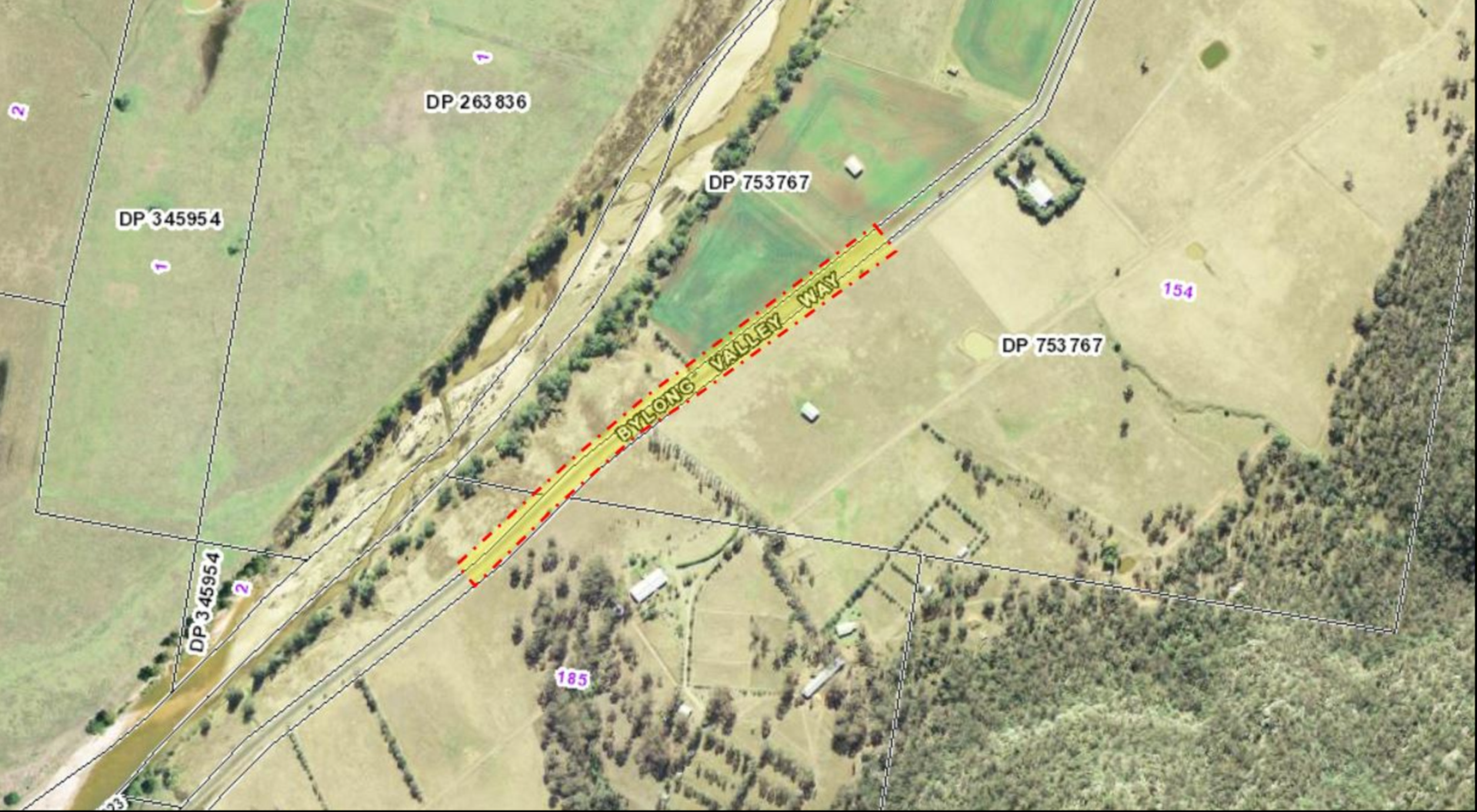

About the Project

Works to upgrade the road and drainage on Bylong Valley Way at CH 5.9Km from Sandy Hollow has commenced. This work will improve the road pavement and drainage over a short section of the road (approximately 400m).

The existing drainage at the location was considered to be inadequate.  The widening of the road pavement will improve safety by providing a sealed road shoulder.

These works are being undertaken as part of the Transport for NSW Regional Roads REPAIR Program, which provides funding for regional roads on a 50:50 basis.

Council has engaged Contractors Hunter Valley Civil (HWC) to carry out the work. Proposed date of completion is 30 June 2023, weather permitting.

Project Update 15/05/2023

Work has commenced on the small section (400m) of road upgrade on Bylong Valley Way, with clearing and grabbing now complete. Road construction to widen and upgrade the pavement is now in progress.

Project Update 22/05/2023

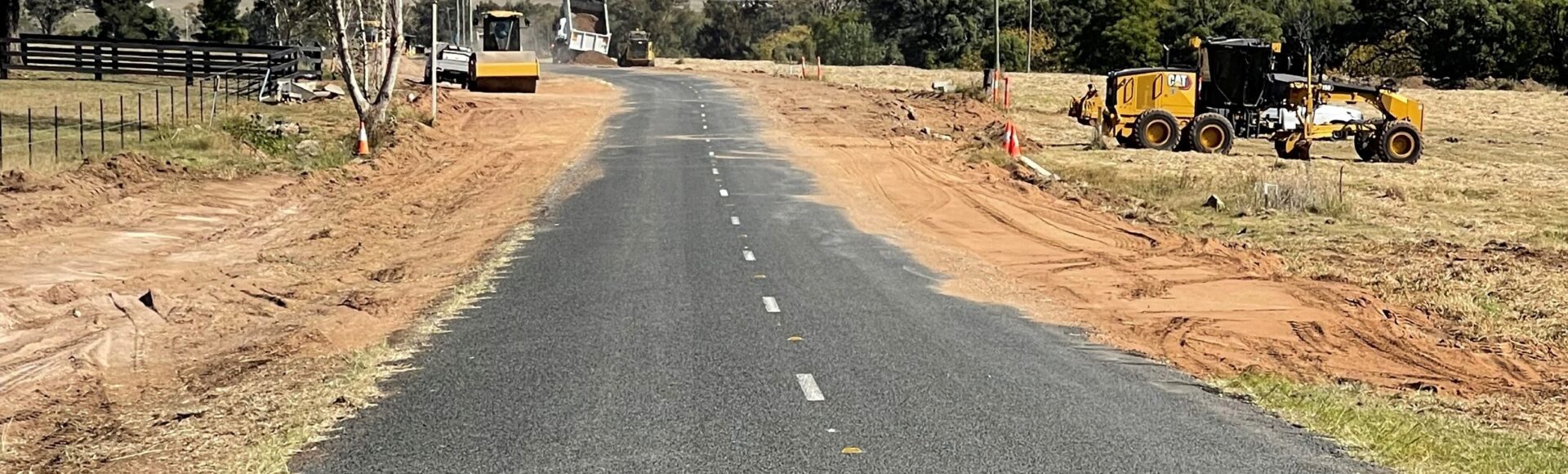

Works are progressing well with road widening and sub grade preparation taking place.

Project Update 30/05/2023

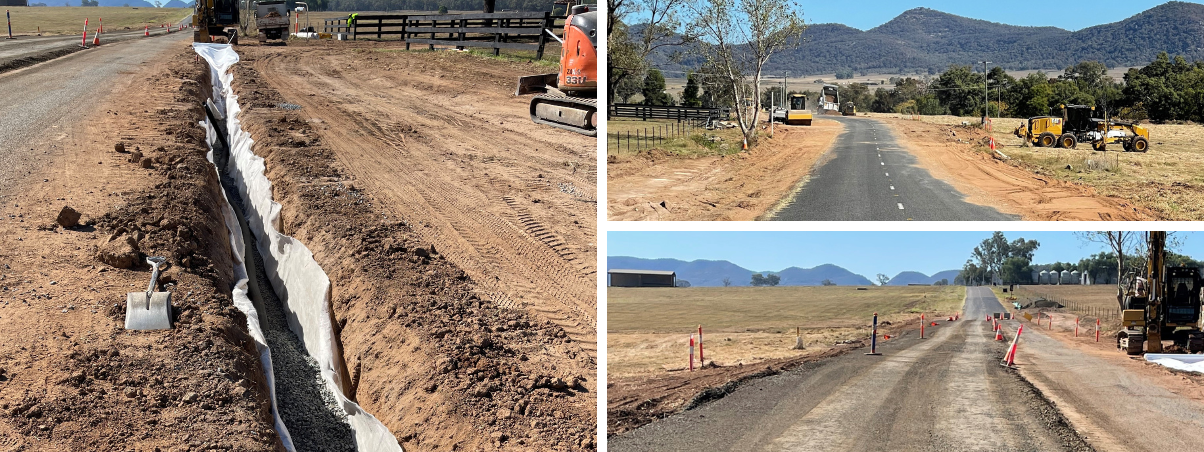

Works are continuing with good progress being made. The subsoil drainage and right-hand side subbase works are in progress.

Project Update 5/06/2023

The subsoil drainage and table drain are complete. The right-hand side subbase work will be continuing next week.

Project Update 19/06/2023

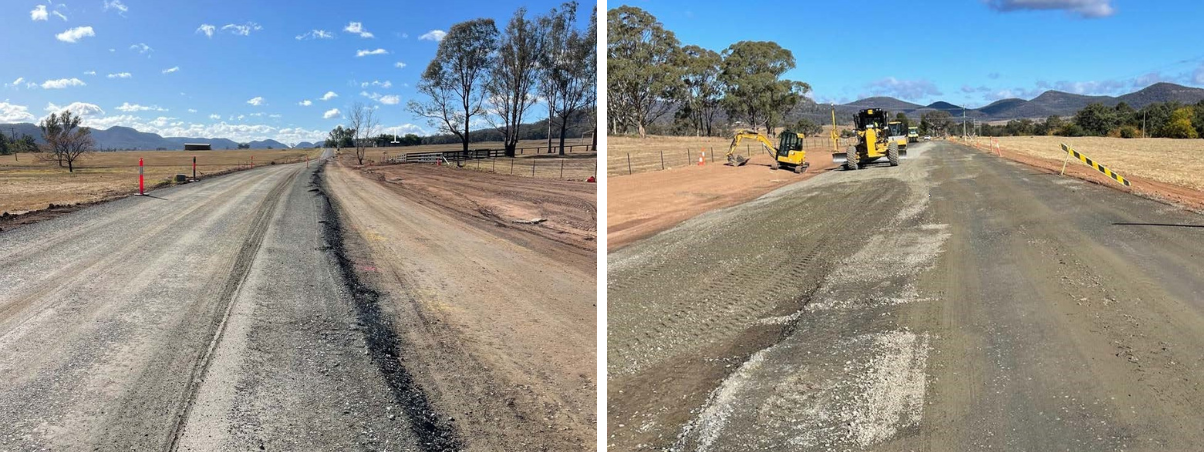

The right-hand road pavement subbase and base work is complete, and works are continuing with finishing the base course. Next week road sealing will commence, weather permitting.

Project Update 17/07/2023

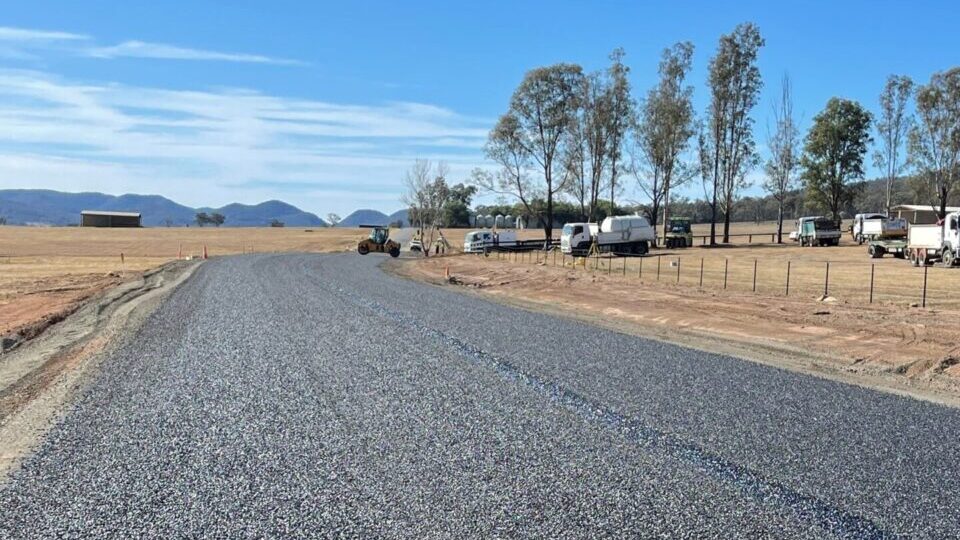

Asphalt works have been completed. Next up is line marking, which is due to commence soon.
